Winegardner Masonry Industries: An Integrated Project, CRM, and Change Order Ecosystem
The Challenge
Change request documents at Winegardner Masonry Industries were prepared manually in Excel, hand-populating project details, cost codes, rates, and markup percentages. There was no standardised structure, milestone framework, or completion visibility across the business.
Winegardner Masonry Industries is a second-generation, SBE-certified union masonry contractor serving Southern and Central California, specialising in commercial, federal, industrial, and large private projects across three divisions: Masonry, Concrete, and ACT.
What Operating Across High Volumes of Concurrent Projects Means
- Project-based scheduling across multiple labour categories
- Complex change order workflows with GC negotiations
- Division-level bid tracking, estimating, and workforce capacity planning

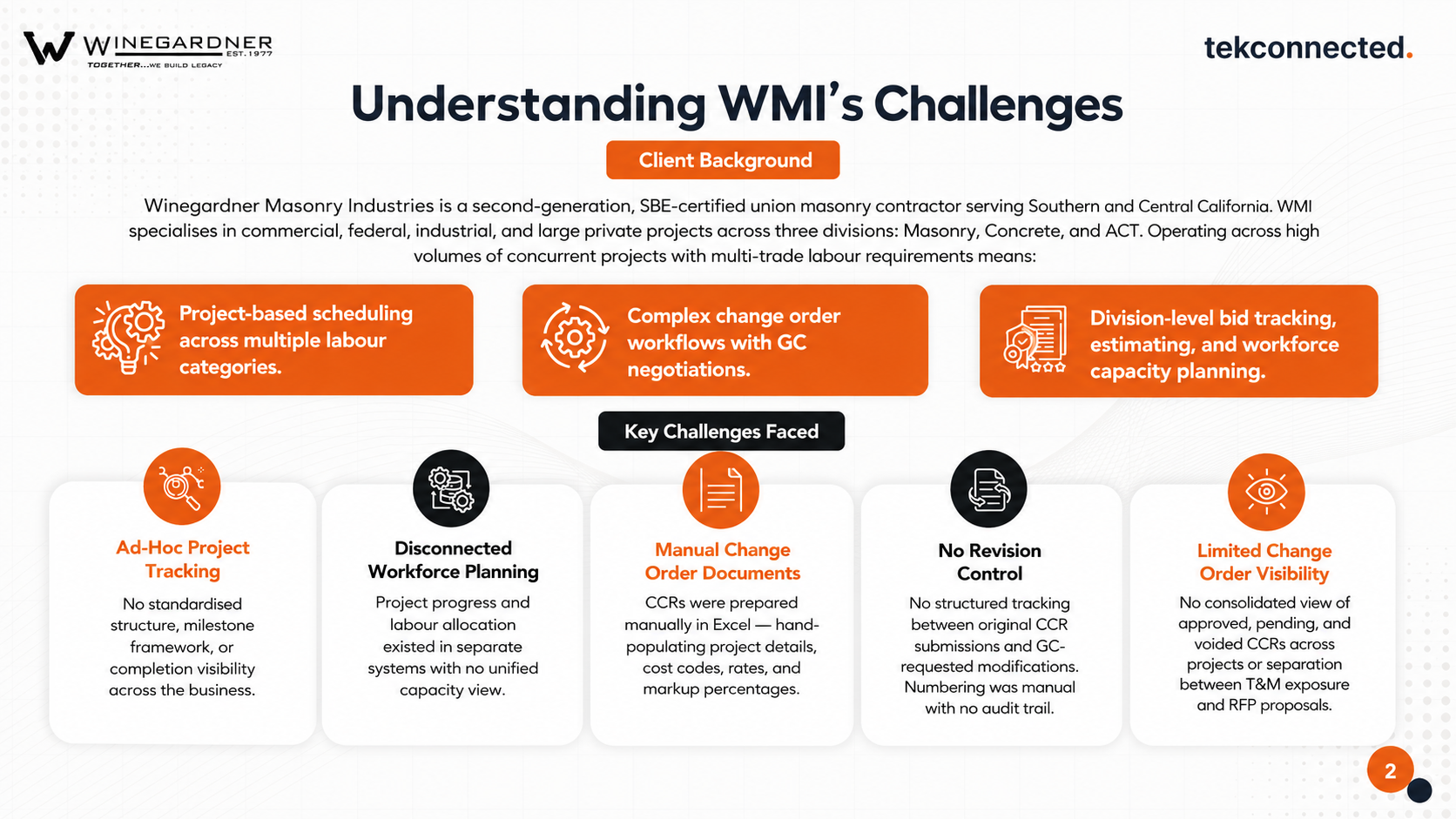

Key Challenges Faced
- Manual Change Order Preparation
- Change request documents were prepared manually in Excel, hand-populating project details, cost codes, rates, and markup percentages.
- No Standardised Project Structure
- No consistent milestone framework or completion visibility existed across projects.
- Disconnected Workforce Planning
- Project progress and labour allocation existed in separate systems with no unified capacity view.
- No Revision Control
- No structured tracking existed between original CCR submissions and GC-requested modifications, and numbering was manual with no audit trail.
- Limited Change Order Visibility
- No consolidated view existed of approved, pending, and voided CCRs across projects, and no separation between T&M exposure and RFP proposals.
The Solution
TekConnected delivered a Monday.com ecosystem combining project management, CRM, and automated change request processing. Five Make.com scenarios connect Monday.com to Google Sheets and Google Drive for document generation, cross-board synchronisation, and real-time progress tracking. Instead of treating these as separate manual processes, each was rebuilt as an interconnected automated system.
Monday.com as the Operational Source of Truth
All project, CRM, workforce, and change order data is structured within Monday.com through standardised project boards, a master tracker, full CRM, capacity tracker, and CCR boards with structured line items.

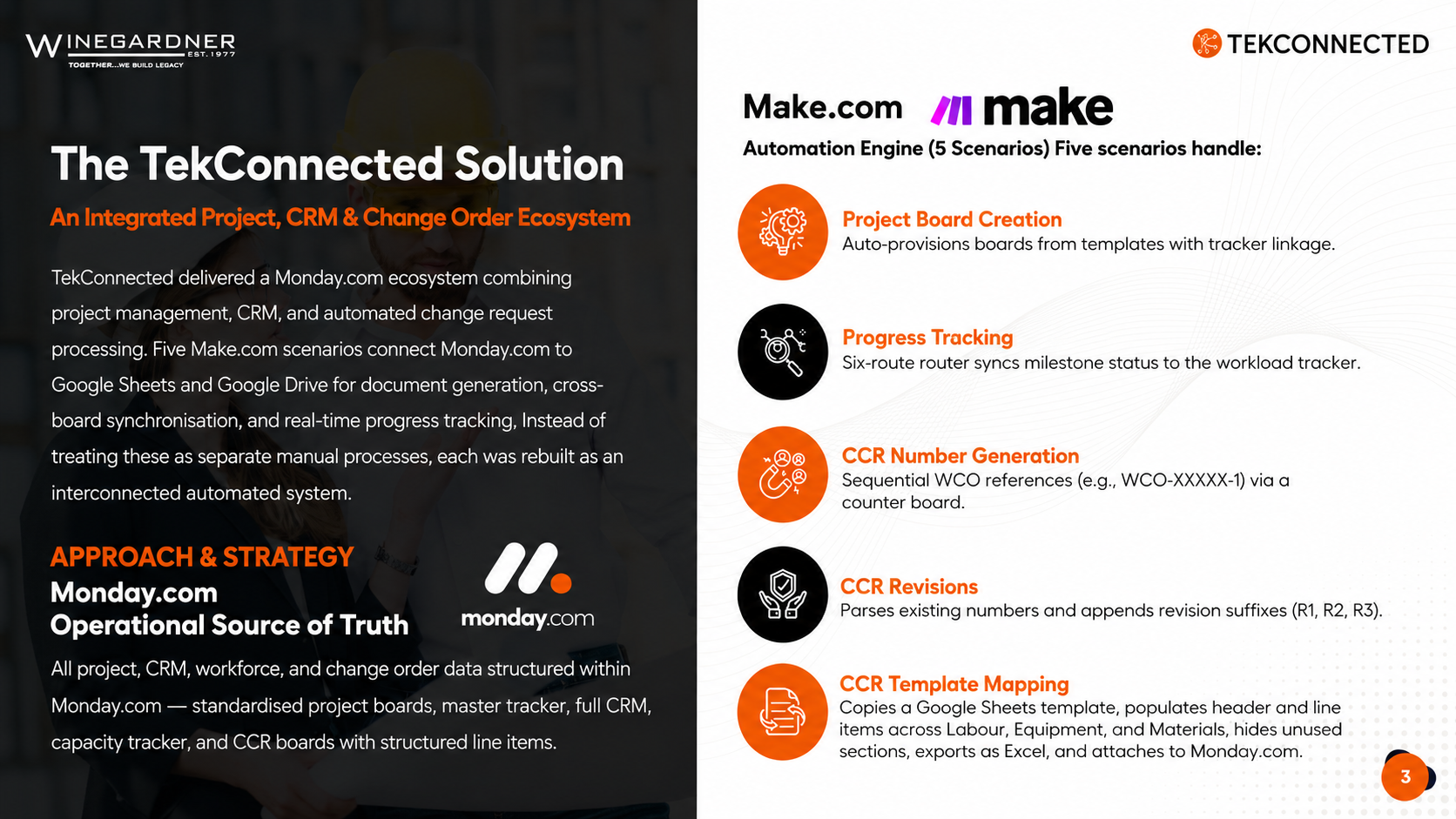

Make.com Automation Engine: 5 Scenarios
- Project Board Creation
- Auto-provisions boards from templates with tracker linkage.
- Progress Tracking
- A six-route router syncs milestone status to the workload tracker.
- CCR Number Generation
- Sequential WCO references, for example WCO-XXXXX-1, via a counter board.
- CCR Revisions
- Parses existing numbers and appends revision suffixes such as R1, R2, and R3.
- CCR Template Mapping
- Copies a Google Sheets template, populates header and line items across Labour, Equipment, and Materials, hides unused sections, exports as Excel, and attaches to Monday.com.
The underlying principle is that construction operations should be system-driven, not admin-driven.
Technology Stack

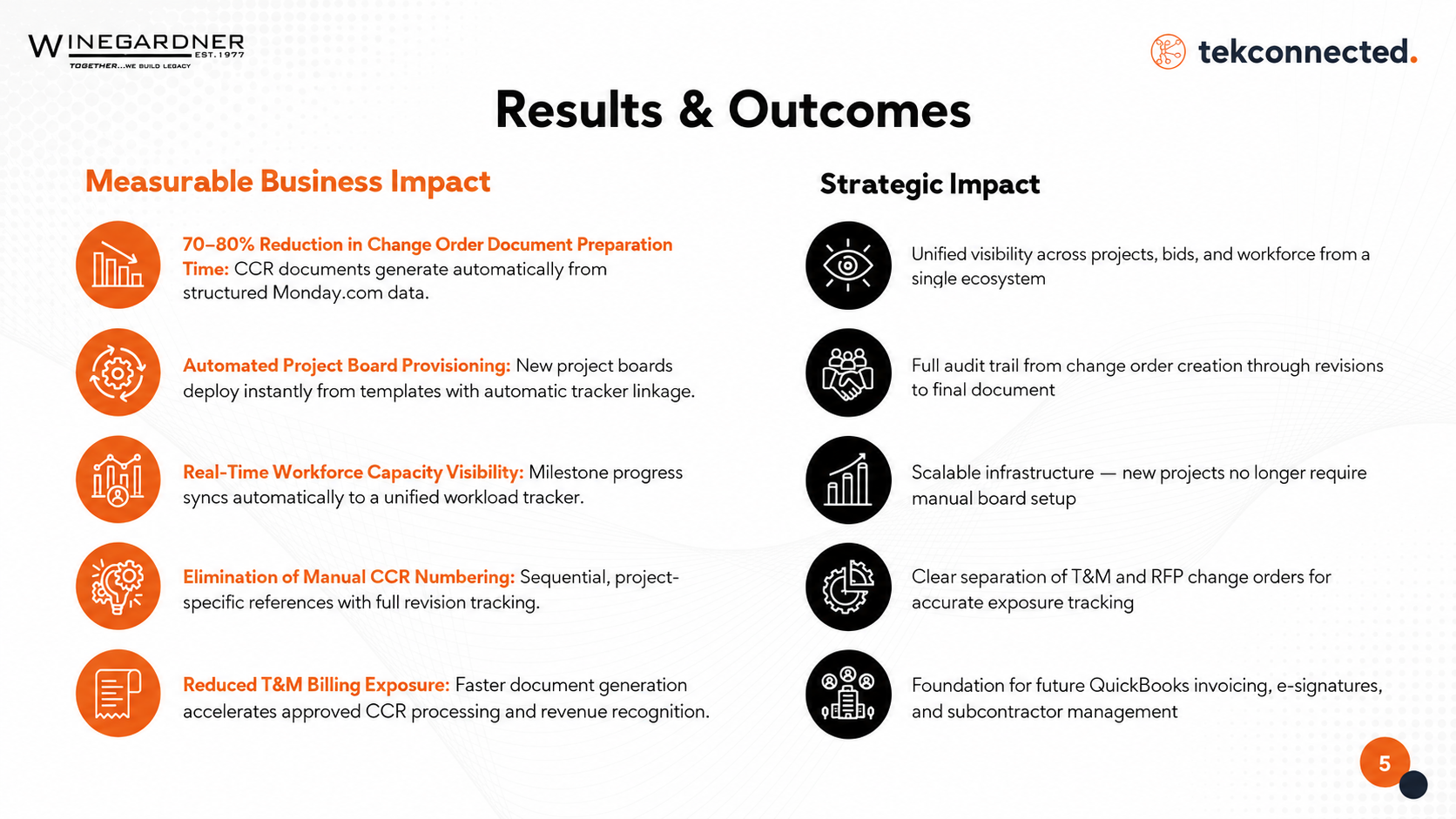

Results & Outcomes
- 70 to 80% Reduction in Change Order Document Preparation Time
- CCR documents generate automatically from structured Monday.com data.
- Automated Project Board Provisioning
- New project boards deploy instantly from templates with automatic tracker linkage.
- Real-Time Workforce Capacity Visibility
- Milestone progress syncs automatically to a unified workload tracker.
- Elimination of Manual CCR Numbering
- Sequential, project-specific references with full revision tracking.
- Reduced T&M Billing Exposure
- Faster document generation accelerates approved CCR processing and revenue recognition.
Strategic Impact
- Unified visibility across projects, bids, and workforce from a single ecosystem.
- Full audit trail from change order creation through revisions to final document.
- Scalable infrastructure, with new projects no longer requiring manual board setup.
- Clear separation of T&M and RFP change orders for accurate exposure tracking.
- Foundation for future QuickBooks invoicing, e-signatures, and subcontractor management.
Who This Applies To
This build pattern fits an organisation that:
- Prepares change orders or project documents manually in Excel
- Tracks projects without a standardised milestone framework
- Lacks consolidated change order visibility across projects
- Relies on manual revision tracking with no audit trail
